March 2025
The Gustav Creek drainage structure, on Sooning Street, Nelly Bay sustained significant damage during the recent rainfall events. More than 2,000mm of rain has fallen in the Gustav Creek catchment since December.
Structural and environmental assessments were completed in late February, with Council staff and consultants meeting with the Department of State Development, Infrastructure and Planning on 20 February 2025 to seek guidance on what type of structure would be acceptable under the current guidelines, acknowledging that any work in Gustav Creek is subject constraints relating to fishways and protected mangroves.
Council is currently working with consultants on preliminary design, demolition plans and delivery programs. Council’s replacement option for the structure has been submitted to the Queensland Reconstruction Authority.
Our teams are regularly on site and are removing debris where possible to lessen the damaged structure’s environmental impact.
We are aware that this week's high rainfalls are having an adverse effect on the road network integrity, particularly Kelly Street, which has increased traffic movements over areas that were damaged earlier this year.
Council will continue monitoring the condition of Kelly Street daily for urgent repairs until restoration of the section between Barton and Sooning Streets occurs after the wet season.
April 2025
Townsville City Council is preparing to remove the damaged culverts that span Gustav Creek on Sooning Street in Nelly Bay. The work will involve excavators and heavy construction equipment to remove broken asphalt and debris washed downstream. Once the work site is clear, demolition of the culverts will occur.
Council plans to transport this material to the mainland via barge. Trucks will transport the material to the Magnetic Island ferry terminal, where barge services will operate to facilitate these works. The frequency of these activities will depend on barge availability.
As the work progresses, there may also be stockpiling of material on-site within the road closure area. These operations will depend highly on weather conditions like rain and high tides.
A local contractor, BMD Constructions, will deliver these works on behalf of Council.
July 2025
Council is working with the State Assessment and Referral Agency (SARA) to gain approvals for the bridge construction. Once we receive SARA approval, we will provide an update on construction timelines.
September 2025
Council is progressing with the design of the Sooning Street bridge in close collaboration with the State Assessment and Referral Agency (SARA). Council, contractors, and SARA have met three times as part of the pre-lodgement process. On 1 May 2025, SARA confirmed that the preferred design is a two-span bridge. During these initial discussions, SARA raised concerns regarding flood flow, fish movement, the existing water main, and rock protection.
On 30 June 2025, the Department of Primary Industries (DPI) agreed to provide pre-lodgement advice for the bridge development application. SARA also confirmed that they would soon issue pre-lodgement advice to help progress the bridge development application.
On 4 July 2025, Council and SARA met to refine the fish passage design and outline the next steps for the development application. Final advice will be provided after DPI reviews the plans. Aligning the design with the State Development Assessment Provisions (SDAP) will simplify the referral process.
Following these three meetings, Council received ‘in-principle’ approval in mid-July to proceed with the detailed design. Since then, SARA has indicated that the design meets their required guidelines. Council will continue to work closely with SARA representatives on this project. Once SARA grants final approval, we will share the details with residents.
Council understands the significance of this connection for daily travel, local businesses, and emergency access, and remains fully committed to restoring the bridge as quickly and safely as possible.
November 2025
Progress continues with several key milestones reached in September 2025. Design drawings for the bridge piles were finalised, and local business Humes has begun manufacturing these foundations.
The project has achieved its 50% design milestone, with both the 50% bridge design and final fishway design lodged as part of the Development Application process through State and Council planning areas.
As part of community feedback received during the October Magnetic Island Residents and Ratepayers Association (MIRRA) meeting, four additional pedestrian signs have been installed on the approaches to the Sooning Street bridge detour to improve safety and visibility.
On 24 September 2025, Council was advised of updated State Development Guidelines. Projects like Sooning Street, which incorporate fishway passages into their designs as part of the development approvals process, may be eligible for certain exemption – in particular if the works are funded under the Disaster Recovery Funding Arrangements (DRFA) program.
Council is also undertaking landscaping maintenance and environmental remediation works within Gustav Creek, commencing Monday 27 October 2025 for one week. This includes the removal of large deadwood debris to help reduce the risk of riverbank erosion, in line with natural waterway design principles.
December 2025
Townsville City Council plans to transport equipment and materials from the mainland to the Sooning Street bridge laydown area in preparation for construction work to begin.
Transportation dates are to suit Department of Transport and Main Roads (DTMR) permits, tide times, barge and tug availability. We expect delivery to occur between Monday 1 December and Thursday 18 December 2025.
Mobilisation activities:
Monday 1 December to Friday 5 December – Mobilise to site
Monday 8 December – Pile platform construction begins
Tuesday 9 December – Delivery of Piles
Tuesday 16 December – Delivery of pre-boring drilling rig, a drilling rig, and a service crane
As part of these works, Council will:
Construct a platform for pile installation

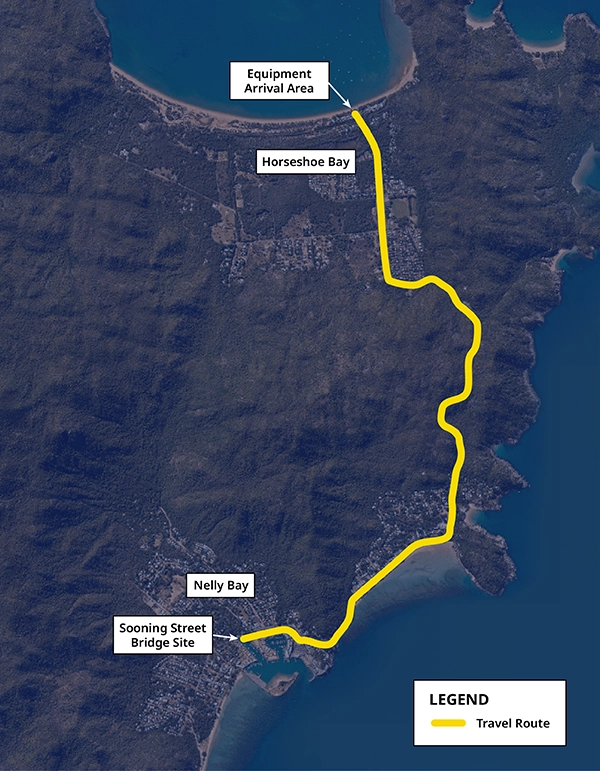

Barge the 28 x 18 metre piles to the Nelly Bay Marina and truck to site
Land a barge on Horseshoe Bay beach to truck equipment to site
Temporary removal of some road signage to allow oversize vehicle access.
Transportation of the equipment from the barge to site will require an oversized heavy vehicle and police escort. Traffic delays are expected – residents and visitors are encouraged to allow extra travel time when commuting around the Island.
Plant and equipment include a pre-boring drilling rig, a drilling rig, and a service crane.

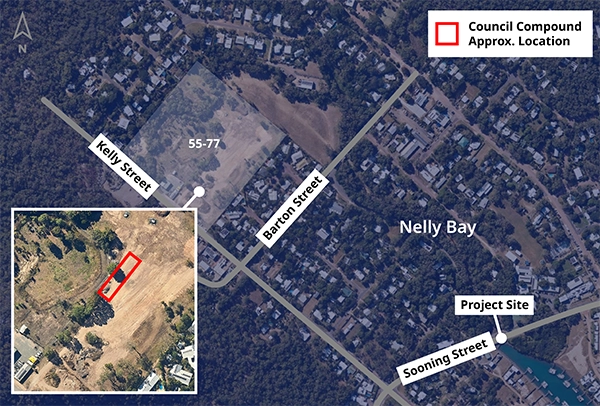

Council has setup a temporary compound at 55-77 Kelly Street to store construction materials that we are unable to stockpile on site.
When not in use, we will store plant and equipment at the compound, alongside storage containers, tools, and materials.
There will be occasions when we deliver formwork, scaffolding, reinforcing steel, and other construction materials to our compound for sorting before transporting to site.
BMD, a local contractor, is delivering these works on behalf of Council.
We will continue to provide updates on our progress and any changes to the schedule.
